Monthly Progress Report for presenting to Top Management and Directors

Monthly Progress Report (MPR) for presenting to Top Management and Directors
Monthly progress report gives an idea about current status of the project and action required for completion of projects without delays or at lessor cost.

The monthly progress report in construction company includes following
- Salient Features of the Project
- Work Status For the Month
- List of Staff at Site
- List of Architectural Drawings received at Site during the month of April.
- List of Structural Drawings received at Site during the month of April.
- List of Services Drawings received at Site during the month of April.
- List of M/C & Equipment Deployed during the month of April.
- Daily Labour Report with Histogram
- Progress Photograph
- Hindrances.

The complete report sample file is attached below, it will help you in creating your one in details.


Attachments

  • Monthy Progress Report.docx
    259.7 KB · Views: 2,456
Wow - That's a lot of data! Is this type of detailed report typical for your industry? I suppose it depends on your targeted audience and the type of data that is needed.....

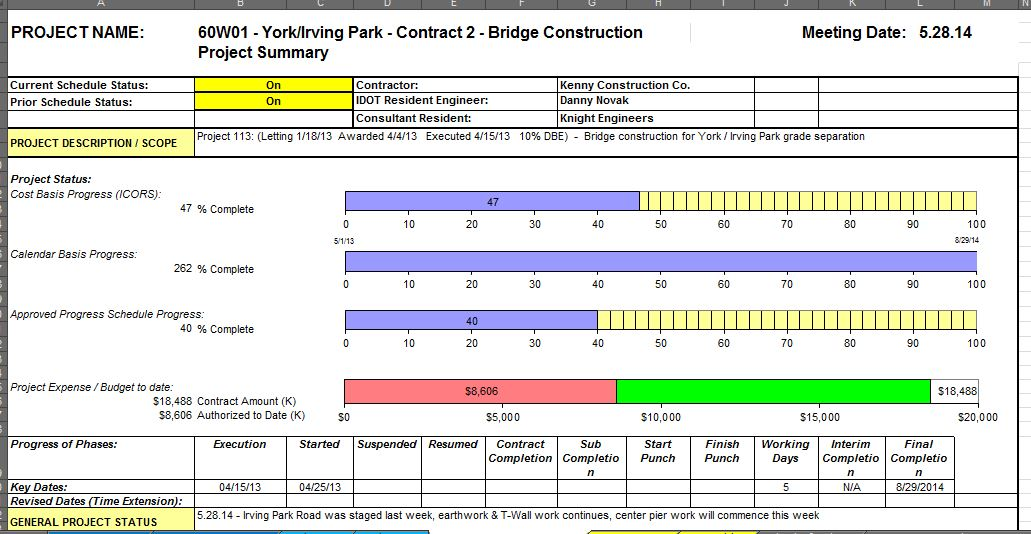

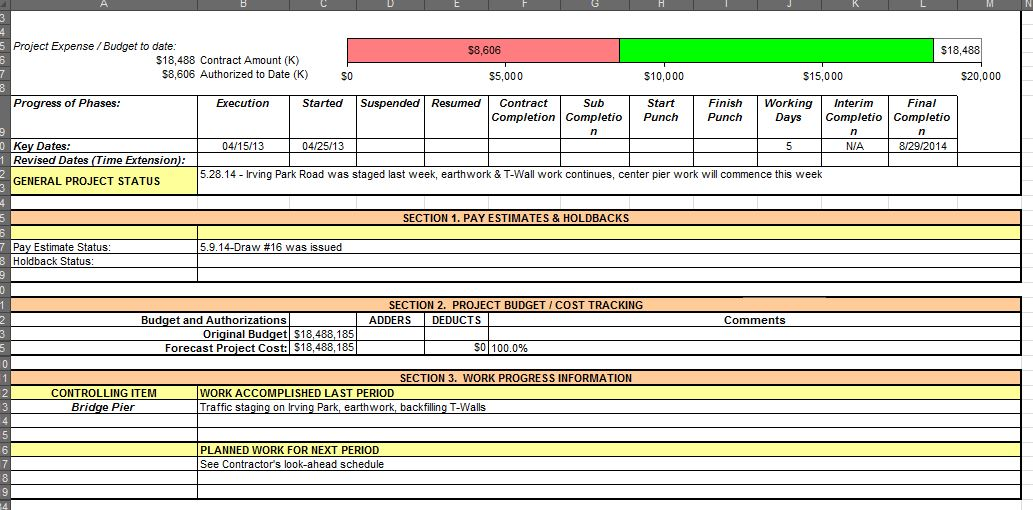

For years I have used a simple "Dashboard" type summary sheet to track key project metrics. Executive & meeting level shapshots or team summaries that are easily-updated and useful to the job players are great tools to have. Here's some additional information on how I apply this tool (I hope it's OK at Civil4M to post resource links like I have - Please let me know if it is not looked-upon favorably.....):
Resident Engineer’s Toolbox-The Dashboard


Monthly Progress Report (MPR) for presenting to Top Management and Directors
Monthly progress report gives an idea about current status of the project and action required for completion of projects without delays or at lessor cost.

The monthly progress report in construction company includes following
- Salient Features of the Project
- Work Status For the Month
- List of Staff at Site
- List of Architectural Drawings received at Site during the month of April.
- List of Structural Drawings received at Site during the month of April.
- List of Services Drawings received at Site during the month of April.
- List of M/C & Equipment Deployed during the month of April.
- Daily Labour Report with Histogram
- Progress Photograph
- Hindrances.

The complete report sample file is attached below, it will help you in creating your one in details.
